| Unverified wind and foundation basis |
A 4.5 m-bay Gothic multi-span concept screened at 0.8-1.5 kN/m2 may be priced with insufficient cable bracing, anchors or foundations if exposure and topography are only assumed. |
The quotation cites a generic wind speed, omits site coordinates, or does not state the governing exposure and load combinations. |
Have the owner-appointed, locally qualified structural professional confirm the applicable design basis before comparing steel mass or foundation scope. |
Site coordinates, exposure and topography assessment, geotechnical inputs, applicable-jurisdiction load basis and signed structural calculation responsibility. |
| Condensation during closed-screen operation |
A woven blackout curtain can reduce natural air exchange; without a coordinated Priva or HortiMaX sequence, HAF fan operation and moisture-removal path, condensation exposure may rise during dark periods. |
The screen schedule is defined, but there is no psychrometric review, RH response sequence or stated action when the 50-65% planning range is exceeded. |
Test the crop schedule, outdoor dew point, HAF fan arrangement and ducted DX or hot-water-reheat duty as one control sequence. Ventilation-led drying may be adequate only where outside-air conditions and blackout hours support it. |
Psychrometric model, screen-opening logic, controls points list, HAF fan schedule and equipment duty confirmation from the responsible climate designer. |
| Critical electrical loads are not separated |
Loss of screen drives, controls, circulation or selected dehumidification can turn a utility outage into an environmental-control event even when total connected load is within the preliminary 15-30 W/m2 illustration. |

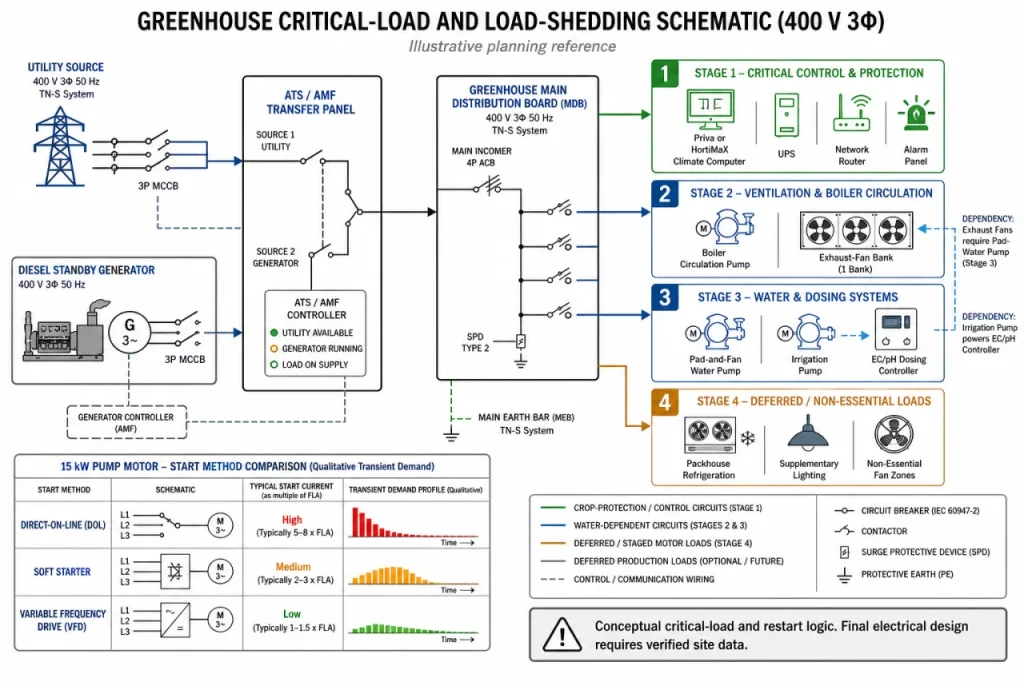

The single-line diagram shows one undifferentiated greenhouse load, or generator capacity is discussed without transfer priorities and autonomy assumptions. |
Define priority circuits for Priva or HortiMaX controls, blackout drives, HAF fans, IP CCTV, access control and the agreed moisture-control equipment. Full-environment backup is not automatically justified where outage tolerance supports a smaller critical-load package. |
Preliminary electrical single-line diagram, utility-capacity response, automatic-transfer sequence, critical-load schedule and backup-power duty basis. |
| Security interfaces are unassigned |
IP CCTV, access-control panels and alarm monitoring can be purchased yet remain uncommissionable when camera supports, cable routes, network switches, dry contacts or backup circuits are absent from every contract. |
The greenhouse quotation includes penetrations only, while the security quotation assumes completed mounting, network and power infrastructure. |
Confirm the security brief with the applicable jurisdiction, licence category and operator requirements, then allocate each physical and digital interface to the greenhouse supplier, security integrator, electrical contractor or owner. |
Approved security-interface matrix, device-location plan, network and power schedule, penetration-detail responsibility and integrated test record. |
| Post-harvest handoff is undefined |
Drying, storage, packaging, waste handling and controlled-access works may be presumed within the greenhouse price, creating late scope gaps at the crop-transfer point. |
Drawings do not identify where crop leaves the greenhouse, utility stub-outs terminate, or which party owns downstream HVAC and fire-system coordination. |
Set a physical transfer point and list each adjacent interface. Early definition adds coordination effort but avoids asking a greenhouse supplier to absorb a processing-facility commitment outside its package. |
Boundary drawing, utility stub-out schedule, room-data responsibility list and documented exclusions accepted by the owner. |
| Water quality is treated as a later operating issue |
UV sterilization, filtration or reverse-osmosis selection can change hydraulic layout, reject-water handling and electrical demand; selecting equipment before source-water results can make the irrigation package unsuitable. |
No recent source-water analysis is included, or the irrigation offer names treatment equipment without feed-water assumptions. |
Obtain source-water testing and have the irrigation designer state the feed-water basis, treatment boundary and drainage disposition before award. |
Laboratory water analysis, irrigation design basis, treatment process description and drainage or reject-water responsibility. |
| Commissioning acceptance is absent |
Multi-vendor systems can be installed but fail to demonstrate blackout sequencing, alarm handoff or critical-power recovery, leaving the owner with an unresolved integration claim. |
Supplier proposals promise commissioning but contain no test list, fault simulation, training record or acceptance owner. |
Include witnessed functional tests for screen operation, Priva or HortiMaX alarms, HAF fans, dehumidification enablement and transfer-power recovery. The contracted parties should agree pass criteria before equipment is ordered. |
Integrated commissioning plan, point-to-point test sheets, alarm and outage test results, training records, warranty-start confirmation and open-items register. |
