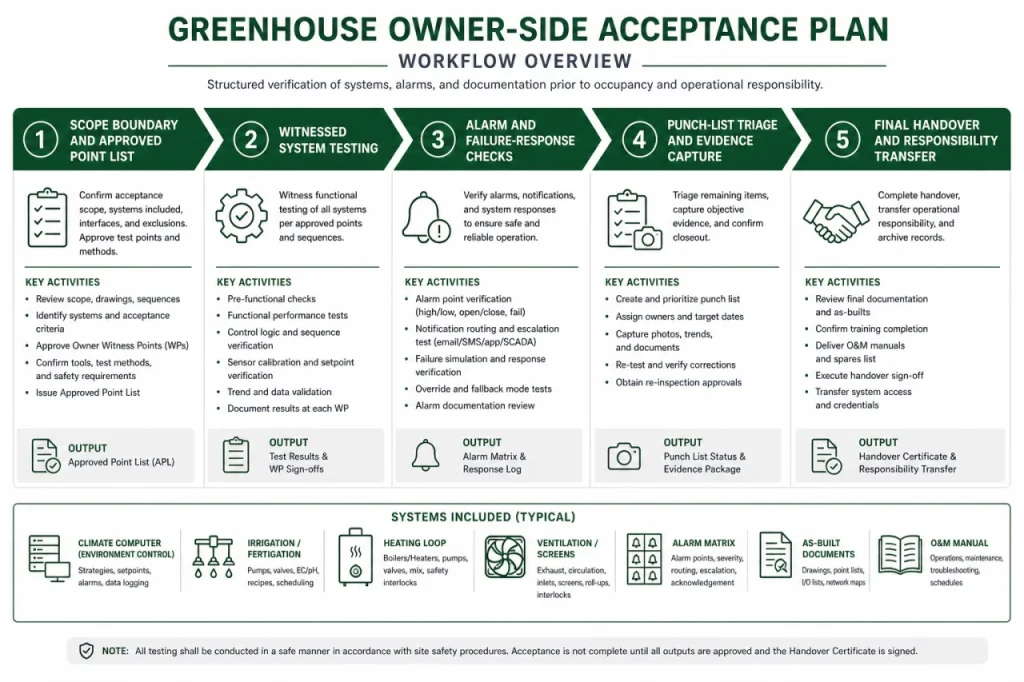

A greenhouse acceptance test plan should not stop at proving that equipment runs in normal mode. Hidden handover risk usually appears when the team forces abnormal conditions and confirms that the control platform, alarm routing and operator response chain behave correctly. In practical terms, that means testing how a Priva or HortiMaX sequence reacts when a value goes out of range, a sensor drops offline, or utility power is interrupted for even 5-15 seconds. If those events are not witnessed before crop loading, the owner may only discover weak escalation logic, wrong alarm recipients or unsafe restart behavior during a live production event. For the decision framework behind this point, review greenhouse water quality requirements.
Forced alarms should be selected from the approved point list and tested one by one against a clear expected result. Useful examples include a high-temperature alarm at an illustrative threshold such as 32-35 degrees C in a warm-zone compartment, low irrigation pressure on a main line at an example 2.5-4.0 bar operating band, high EC deviation on the dosing skid, screen travel fault on a thermal screen drive, and communication loss between field I/O and the climate computer. The point is not to prove a universal setpoint; it is to confirm that the correct alarm appears, the timestamp is recorded, the right person receives it, and the commanded fallback action actually occurs. A practical planning scenario appears in high-wire tomato greenhouse project.
Sensor disconnect testing is especially valuable because many commissioning demonstrations only show stable readings. A more defensible greenhouse handover checklist should include deliberate loss-of-signal tests for at least one air temperature sensor, one RH sensor, one irrigation pressure transmitter or flow meter, and any critical EC/pH dosing feedback loop. If a temperature sensor with an expected planning tolerance of around plus or minus 0.5 degrees C goes offline, the owner should verify whether the control platform holds last value, substitutes a backup sensor, shifts to manual mode or triggers an immediate alarm. That decision affects crop risk directly, especially in a Venlo greenhouse or other integrated high-tech facility where ventilation, heating pipe temperature and screen position are all linked through the same logic stack.
Power-loss logic deserves separate attention because a clean restart is not the same as a safe restart. The acceptance team should verify what happens after a brief outage of 5-30 seconds versus a longer outage that requires backup generator or transfer-switch action, if those systems are in scope. At minimum, confirm which devices auto-recover, which stay latched out, whether alarm history is retained, and whether pumps, vent motors, boiler enable signals or dosing commands restart in the correct order. For projects with integrated utilities or complex controls, it is often worth cross-checking the acceptance logic against the broader commercial greenhouse operations readiness guide so restart behavior matches actual operating responsibility, not just installation completion.
Escalation-path testing is where many owners find gaps that a supplier demo does not reveal. A greenhouse system testing plan should verify not only that an alarm exists, but that it reaches the first operator, then escalates to a second contact if no acknowledgement occurs within an illustrative window such as under 60 seconds for a high-priority event. That matters more than it sounds: an unacknowledged boiler fault, fertigation failure or ventilation stop can become a crop-loss event long before the handover debate is resolved. If the project uses outsourced operations, remote supervision or split day-night staffing, the escalation chain should be tested with the actual phone numbers, user permissions and notification channels that will exist after sign-off. A practical planning scenario appears in greenhouse retrofit and phased expansion planning scenario.
Because these tests can involve electrical panels, moving vent drives, pressurized hot-water loops, gas-fired equipment or CO2-linked interlocks, the method should stay project-specific and follow safe-work controls. Abnormal-condition simulations may require lockout or controlled isolation before work begins, especially where unexpected startup, stored thermal energy above 70 degrees C, or motorized movement across spans of 2-4 m could expose personnel. The owner’s role is to witness and record the result; the qualified contractor, integrator or specialist should control the test method and any reset procedure. If your contract still treats alarm checks as an informal SAT demonstration, this is usually the point to tighten the acceptance language before demobilization or final handover.
