When Greenhouse CO2 Enrichment Belongs in the Early Budget

Learn when greenhouse CO2 enrichment is worth budgeting early, when venting and leakage weaken the case, and what supplier scope must be defined before tender.

By Aegis Greenhouse Systems Editorial Desk

Published /Updated

Decision support

Compare the three budget paths

Use the include-now, phased-provision and exclude comparison to judge which path fits your retention window, crop value and operational discipline.

Check scenario fit before pricing

Test whether high-wire tomato, low-light crops, frequent venting, retrofit constraints or weak monitoring habits change the answer before adding CO2 scope.

Prepare the inputs suppliers will need

Gather crop calendar, DLI context, vent-opening pattern, heating source, climate computer platform, alarm requirements and calibration ownership before tender discussions start.

When Greenhouse CO2 Enrichment Belongs in the Early Budget

The short answer: budget CO2 only when the greenhouse can keep and use it

For early planning, CO2 enrichment is not a default line item. It belongs in the first budget only when a commercial greenhouse can hold a useful enrichment level for enough productive hours that the crop can actually respond. In practical planning terms, a 700-1,000 ppm target is only meaningful if the crop sees that range inside a reasonably retained environment rather than losing it quickly through vent opening or leakage. This section uses reference-scenario guidance for concept budgeting, not a site-specific design or verified project result.

Budget path What it means When it fits
Include now Carry first-budget allowance for the main CO2 enrichment package and core control integration. Best fit where crop light is strong, venting periods are limited, leakage is relatively controlled, and the operating team can manage setpoints, sensing and daily follow-through.
Phased provision Protect future CO2 readiness in the concept, but delay full investment until feasibility is clearer. Usually the strongest middle path when the crop case looks promising but vent losses, climate pattern, or operational discipline are still uncertain.
Exclude Leave CO2 out of first-tender budget scope and spend attention elsewhere. Makes sense when frequent vent opening, high infiltration, low crop light, or weak monitoring discipline would make enrichment hard to retain or use well.

The decision is controlled less by the headline ppm target and more by four linked realities: how often vents open, how much air leaks through the envelope, whether the crop has enough light to use added CO2, and whether the operation can manage climate setpoints consistently. If those conditions are weak, adding CO2 too early can make the budget look more advanced without improving the actual production concept. Use commercial greenhouse utility planning when you need the wider comparison criteria behind this point.

Why a 700-1,000 ppm target means little without vent opening, leakage and crop programme

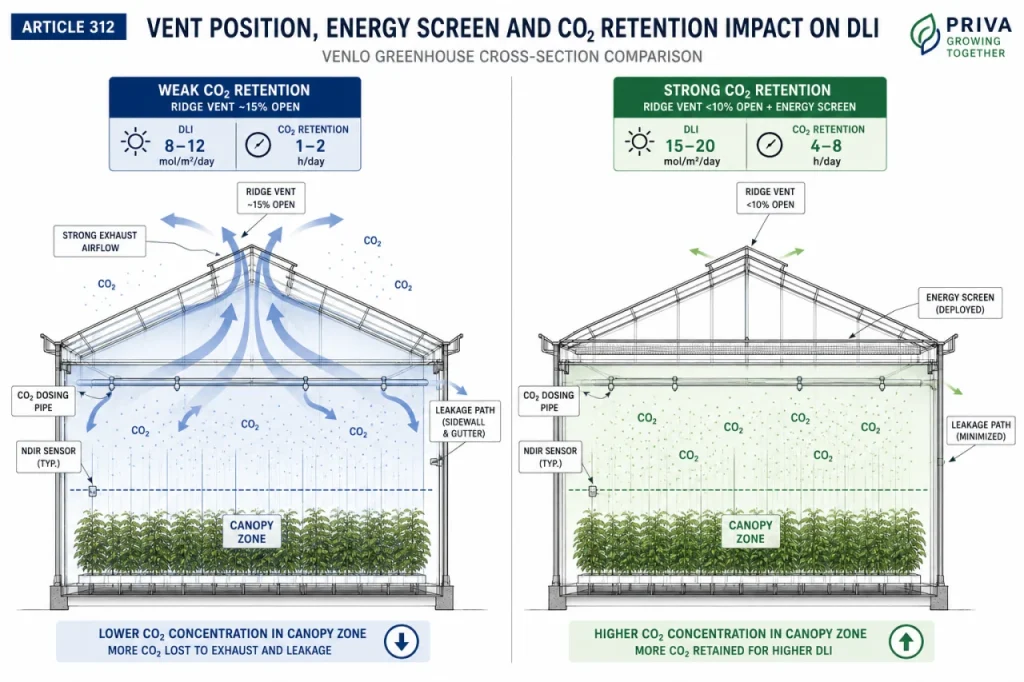

Diagram comparing weak and strong greenhouse CO2 retention scenarios based on vent opening, light level, and retention hours
A 700-1,000 ppm target has different budget value when the greenhouse holds CO2 for 1-2 hours versus 4-8 productive hours per day.

A 700-1,000 ppm setpoint is only a control target, not proof of greenhouse CO2 system feasibility. The real question is whether the crop can see that concentration for enough productive time inside the greenhouse envelope. If a Venlo greenhouse is running with ridge vents opened beyond roughly 10-15% for long daytime periods, or if side leakage and door traffic are high, added CO2 can leave the air mass faster than a high-wire canopy can use it. In that case, the budget issue is not the ppm target itself; it is the weak retention window behind it.

This is why productive hours matter more than headline concentration. As a planning comparison, a crop that can hold enrichment for only 1-2 hours/day during useful light periods is in a very different commercial position from a crop-climate setup that can hold it for 4-8 hours/day. University extension guidance on greenhouse CO2 enrichment supports this conditional logic: crop response depends on the surrounding environment and management, not on concentration alone. Light level is central here. A DLI band around 8-12 mol/m2/day usually offers a weaker response case than a 15-20 mol/m2/day production window, especially when the crop programme does not maintain strong vegetative and fruiting demand across the same season. For the relevant greenhouse platform, see glass greenhouse climate-control setup.

Dependency Weak-fit scenario value Stronger-fit scenario value Why the decision changes
Daytime vent opening Above roughly 10-15% for long periods Mostly closed or only lightly opened during enrichment hours Large vent area increases CO2 loss and reduces the value of each kg dosed
Productive retention window About 1-2 hours/day About 4-8 hours/day More retained hours give the crop more time to convert added CO2 under useful radiation
Light context DLI around 8-12 mol/m2/day DLI around 15-20 mol/m2/day Higher light generally improves the chance that enrichment translates into useful photosynthetic gain
Crop programme Lower-intensity or seasonal gaps in demand Consistent high-wire production calendar The crop must have enough active demand during the same periods when CO2 can realistically be retained

Seasonality changes the answer further. A winter tomato programme with low outside temperatures and reduced venting may justify CO2 very differently from a warm-season programme that spends much of the day venting for temperature control. If you need a broader view of how climate control, screening and automation shape that outcome, the greenhouse technology comparison resource helps place CO2 within the wider climate-control strategy rather than treating it as an isolated add-on.

The readiness gates that make CO2 more plausible

CO2 becomes more credible when light, retention, heating and control discipline line up at the same time. A project that passes only one or two of these gates usually turns a 700-1,000 ppm target into a budget line with weak real-world use. The broader evaluation context sits in operations readiness for climate-controlled greenhouse systems.

Gate What to look for Stronger-fit signal Fail signal What the decision affects
1. Crop value and intensity Check whether the crop has enough margin and production intensity to justify added gas cost, controls scope and operator attention. High-wire tomato on a 4-8 hectare Venlo greenhouse, long season, dense canopy, high-value packout. Low-value crop, short cycle, or inconsistent crop programme that cannot defend ongoing CO2 spend. If this gate fails, CO2 usually drops behind irrigation, screening or labor-efficiency upgrades in budget priority.
2. Light context and production window Look at whether the crop will see useful enrichment during periods closer to 15-20 mol/m2/day DLI rather than spending most of the season near 8-12 mol/m2/day. High-light months, extended production season, and crop scheduling that places peak fruit load into brighter periods. Low-light seasonality, winter-heavy programme, or crop timing that leaves little photosynthetic demand when the house is closed. This gate determines whether CO2 has enough productive hours to matter, not just whether the hardware can dose gas.
3. Energy-screen strategy and leakage control Ask whether the greenhouse envelope can retain gas reasonably well when vents are near closed and the energy screen is deployed correctly. Single or double energy screen, controlled vent crack, limited side leakage, and a glasshouse or sealed multi-span concept with disciplined maintenance. Frequent uncontrolled leakage, worn seals, open side conditions, or an energy screen strategy that is absent or poorly integrated. A good screen package can improve retention windows; it does not rescue a leaky structure by itself. See the energy screen integration planning context for why control coordination matters.
4. Heating path and CO2 source relationship Confirm whether the project has a realistic source path such as liquid CO2 supply or a verified combustion-linked route tied to a hot-water heating circuit. Stable fuel and utility planning, boiler or CHP-related concept under review, or dependable bulk CO2 logistics within the site operating model. No practical gas supply path, uncertain fuel strategy, or assumption that a heating plant automatically solves gas quality and dosing suitability. This gate affects whether CO2 is a real operating system or just an idea with missing source economics and interface risk.
5. Climate computer and sensor discipline CO2 dosing needs climate-computer logic, zone control and sensor feedback from calibrated NDIR sensors, not manual guesswork. Defined climate computer platform, CO2 strategy tied to vent position and screen position, and sensor coverage by zone with 1-2 sensor points per compartment as a planning baseline. No integrated controls logic, no clear response to vent opening, or sensors treated as optional accessories. If this gate is weak climate-control and automation fit usually needs review before CO2 is budgeted as core scope.
6. Operational monitoring and calibration ownership Someone must own alarm response, trend review, calibration gas, and sensor verification on a 6-12 month reference-baseline cycle. Named operations lead, documented calibration responsibility, occupied-area alarm review, and commissioning handover that includes staff training. Unclear ownership after startup, no calibration plan, or assumption that the supplier will manage long-term tuning without scope. This gate often decides whether a technically valid CO2 concept performs consistently or drifts into wasted dosing and unreliable readings.

If several gates look uncertain rather than clearly positive, that usually points to a concept-stage review before CO2 is treated as committed scope. For cost-category context, the broader commercial greenhouse cost planning resource helps place CO2 beside other first-budget priorities.

How the answer changes by scenario

The same CO2 budget decision looks very different in a high-wire tomato glasshouse than in a frequently vented, lower-light concept. The point is not to force one rule across every project, but to see which commercial pattern your greenhouse actually matches before CO2 enters the early budget. Use greenhouse investment guide when you need the wider comparison criteria behind this point.

Scenario Typical fit Main constraint Trade-off Next question
New intensive high-wire tomato block A new tomato greenhouse in a Venlo glasshouse or glasshouse concept, with DLI often in the 15-20 mol/m2/day range during stronger seasons, daytime vent opening often held below roughly 10-15% for meaningful periods, and an energy screen strategy coordinated through a climate computer. The case is stronger only if the greenhouse can hold enrichment for roughly 4-8 productive hours/day in key production periods rather than losing it after short closed-window intervals. Higher crop value can justify earlier CO2 scope, but the operating model also becomes less forgiving: tighter control discipline, cleaner utility planning, and more consistent staff response to alarms and sensor drift are required. Can the project maintain long enough retained periods in the target season, and does the concept resemble the intensive production logic shown in this high-wire tomato facility context?
Naturally ventilated or frequent-vent climate A multi-span or naturally ventilated concept in warm conditions where ridge or side vent opening is often above roughly 10-15% through large parts of the day, especially when solar load and humidity force frequent air exchange. Retention breaks down quickly. Even if the control target is 700-1,000 ppm, the crop may only see a useful uplift for roughly 1-2 hours/day, or less, before vent loss dominates. Budgeting full CO2 scope too early can tie capital to a weak-use case. The trade-off is that excluding it now may be smarter than carrying a large gas system that the climate pattern rarely lets you use effectively. How many hours in the real crop calendar are likely to run with low vent opening, and would that window still justify dosing after summer ventilation realities are considered?
Retrofit with partial readiness An existing greenhouse where some ingredients already exist, such as a hot-water heating circuit, climate computer, or energy screen, but leakage, zoning, or old vent hardware still limit retention. This is often where phased retrofit planning matters most. The project may be technically possible but commercially uneven. Utility access, legacy pipe routing, and mixed-condition compartments can raise retrofit complexity faster than the first budget suggests. This is often the strongest case for phased provision rather than full first-tender commitment: preserve controls points, space, and routing allowances now, while delaying full dosing hardware until retention and operating discipline are clearer. Which existing systems are reusable, and does the retrofit need envelope or screen improvements first to avoid funding CO2 before the structure can reasonably keep it?
Lower-value or lower-light crop programme Crop programmes with lower market value, shorter production intensity, or lower-light conditions around 8-12 mol/m2/day for long periods, where the crop response case is usually less resilient to gas cost and retention losses. The weak point is not only climate. It is also margin sensitivity: if the crop value is modest, CO2 can become a second-order optimization instead of a first-order budget priority. The trade-off is opportunity cost. Money reserved for CO2 may deliver less benefit than better screening, dehumidification control, irrigation reliability, or other core systems. Future expansion still matters, so a limited provision path can be better than a full omission when scale-up is likely. Would the same budget produce more reliable return if allocated first to climate retention, labor workflow, or another core system before enrichment is reconsidered?

If you are still uncertain which row best matches your project, compare your climate-control concept against the broader greenhouse technology comparison and review how screen integration changes retention logic in this energy screen specification context. Those references help frame whether CO2 belongs in the first concept, later provision, or not in the initial scope at all.

Choose the budget path: include now, phased provision or exclude

The most expensive mistake is often not leaving CO2 out of the first budget. It is carrying full scope too early, then discovering that the operating case or tender definition is still too weak. In early planning, the practical decision is not simply yes or no. It is whether CO2 should be fully priced now, protected as a future-ready provision, or removed from first-tender scope so budget is preserved for higher-priority climate items. The broader evaluation context sits in commercial greenhouse project budget planning.

Budget path When appropriate Upside Downside Next validation step
Include now Best fit for a new high-wire tomato greenhouse or similar intensive crop where the concept already assumes a climate computer, energy screen, and a defined CO2 path such as liquid supply or cleaned flue-gas integration. Supplier pricing is more complete from the start, control architecture can be coordinated early, and DN40-DN75 distribution routing or manifold space does not need to be retrofitted later. Highest first-phase capex and greater exposure if crop mix, operating discipline, or utility assumptions change after tender. Confirm that the first tender will carry full source, distribution, controls, alarms, commissioning, and operator handover as a single priced package.
Phased provision Often the strongest middle path when the greenhouse concept looks promising but crop programme, seasonal operating pattern, or heating strategy still need confirmation. Typical provision items include spare I/O on the climate computer, reserved pipe routes, plantroom space, and alarm architecture. Protects future flexibility while avoiding immediate spend on tanks, vaporizer capacity, burners, or full dosing hardware before the business case is mature. Later installation usually costs more per m2 than doing everything at once, and weak documentation can still create redesign risk if future interfaces are not defined clearly. Write the provision scope explicitly: reserved control points, mechanical allowances, electrical capacity, and future connection boundaries should all appear in tender notes.
Exclude Best when the first budget is already constrained, the crop has lower value density, or the project still lacks confidence on operational readiness. This is common in simpler multi-span concepts or cost-led first phases where better envelope control and irrigation accuracy offer clearer early returns. Keeps budget focused on primary performance drivers and reduces distraction in early procurement. Future CO2 addition may require rework to structure interfaces, plantroom layout, or controls if no allowance is preserved. Record the exclusion as intentional, and decide whether any low-cost future allowance such as cable tray space or one capped branch connection should still be protected.

For many projects, phased provision is the most commercially disciplined answer. It fits situations where the concept is credible enough to protect future expansion, but not yet strong enough to justify full first-pass spend. That is different from indecision: it is a deliberate scope choice that limits stranded capex while keeping the option open. If the decision now depends on platform type, multi-span greenhouse in warm venting conditions is the next useful reference.

If you need the broader budget context around utilities, controls, structure, and fit-out, review commercial greenhouse cost categories and planning sensitivities. That resource helps place CO2 in the full investment picture without widening this article beyond the budget-path decision.

FAQ

Frequently asked questions

What crop and climate conditions usually justify CO2 enrichment in an early budget?+

CO2 is more likely to belong in the first budget when the crop is high-value and light-responsive, the greenhouse can stay relatively closed for meaningful daytime periods, and the climate strategy supports retention rather than constant venting. In practice, that usually points more toward intensive tomato greenhouse production in a controlled Venlo or glasshouse format than toward lower-light or frequently vented concepts. A planning scenario with daytime light around 15-20 mol/m2/day and 4-8 productive retention hours is very different from a lower-light 8-12 mol/m2/day programme that must vent early and often. If the crop margin is modest or the hot season forces long periods of open ridge vents, CO2 often belongs as phased provision or stays out of the first tender.

Why is a 700-1,000 ppm target not enough to judge feasibility?+

Because 700-1,000 ppm is only a control target, not proof that the crop will receive useful exposure. University extension guidance on greenhouse enrichment supports the broader point that crop response depends on environmental and management conditions, not concentration alone. If side leakage is high, ridge vents are partly open, or the crop is in a low-demand seasonal phase, the setpoint can look correct on the climate computer while the commercial value remains weak. That is why this article treats ppm as one variable inside a wider greenhouse CO2 system feasibility check, not as a standalone buying trigger. If this question is turning into a specification decision, greenhouse crop selection guide gives the fuller framework.

When is phased provision smarter than full CO2 scope in the first tender?+

Phased provision is usually the better middle path when the crop case looks plausible but one or two major conditions are still uncertain, such as summer venting pattern, local liquid CO2 logistics, or whether the climate computer and NDIR sensor architecture will be standardized across zones. In that case, it can make sense to reserve control points, pipe routing space, and alarm interfaces now, while delaying the full dosing package until the operating model is clearer. If you are still comparing climate-control architectures, the broader greenhouse technology comparison resource is the better next step.

How does frequent vent opening weaken the investment case for commercial greenhouse CO2 dosing?+

Frequent vent opening weakens the case because the greenhouse loses enriched air faster than the crop can convert it into yield or quality value. As a planning scenario, once daytime vent opening moves above roughly 10-15% for long periods, retention usually becomes weak enough that a 1-2 hour useful window may replace a stronger 4-8 hour window. That does not make CO2 impossible in every case, but it often changes the budget answer from include now to phase or exclude. This issue is especially important in naturally ventilated or hot-season projects where venting is a daily operating requirement rather than an occasional event. See high-wire tomato greenhouse project scenario for a scenario-level view of the decision.

What should suppliers clarify before CO2 enrichment stays in project scope?+

They should clearly state whether scope includes the CO2 source path, dosing manifold, DN40-DN75 distribution piping reference band, zone valves, NDIR sensors, occupied-area alarms, climate-computer integration, calibration materials, commissioning, and operator training. Worker-safety interfaces should not stay implied: OSHA and NIOSH context makes it clear that occupied-space monitoring and alarm responsibility matter even though crop setpoints and workplace limits are different questions. If you are testing how these items affect first-budget sensitivity, the commercial greenhouse cost resource helps place CO2 inside the wider project cost structure.

What should be checked before turning this into a supplier decision?+

The right answer depends on crop, climate, operating goals, utility reliability, maintenance capability and budget. Use this article to narrow the decision, then talk through the remaining site-specific variables before locking scope, supplier direction or budget.

Turn CO2 from a vague idea into a scoped budget decision

Share your crop plan, greenhouse type, climate context, venting pattern and control strategy. Aegis can help determine whether CO2 should be included now, carried as phased provision, or excluded from the first budget while protecting future flexibility.
